Why Do AI Projects Stall Between PoC and Production? 12 Company Mistakes

The PoC worked during the presentation. The model answered questions correctly, classified documents, or recommended the next action. But when the company tried to connect the solution to real data, systems, and workflows, the project started losing momentum. Problems appeared around response quality, integrations, security, costs, or responsibility for the outcome.

This is where many AI initiatives stall for months or never reach production at all. The root cause is rarely just the wrong model. More often, the organization has not defined the problem precisely enough, prepared the data, designed the full solution, planned testing, or divided ownership between business teams, IT, and the technology partner.

In this article, we examine 12 mistakes companies make when moving an AI PoC to production. We also provide an operational framework for CTOs to decide whether a project is ready to deploy, needs to be redesigned, or should be stopped.

In short: a successful PoC confirms that an idea is technically feasible. It does not yet confirm that the solution:

  • solves a business problem important enough to justify investment,
  • works on production data,
  • integrates with the company’s workflow and systems,
  • meets quality and security requirements,
  • can be monitored and maintained,
  • has an accountable owner and a justified total cost of operation.

Why is a working AI PoC not enough?

Definition: an AI proof of concept, or AI PoC, is a limited experiment designed to verify whether a specific technical concept can work under controlled conditions. Its purpose is not to prove that the solution is ready to support a real business process.

During a PoC, the environment is usually simplified. Teams work with a selected dataset, a small number of users, manually refined prompts, or a single integration. Edge cases, error handling, access controls, comprehensive monitoring, and the operating model are often deliberately left out.

That simplification is appropriate because the PoC is supposed to answer a focused question quickly. The problem begins when the organization treats a positive experiment as approval for immediate scaling.

A PoC proves feasibility. Production requires repeatability.

A production solution must work beyond a prepared demo. It should maintain an acceptable level of quality when data changes, traffic increases, dependent systems fail, the model is updated, users behave unpredictably, or someone attempts to bypass security controls.

The key difference: a PoC answers “Can this work?” A production deployment must answer “Can we deliver value safely, repeatedly, and economically inside a real business process?”

The decision to move into production therefore cannot be based only on model output quality. It requires a simultaneous review of business value, data, integrations, architecture, testing, security, operations, and cost.

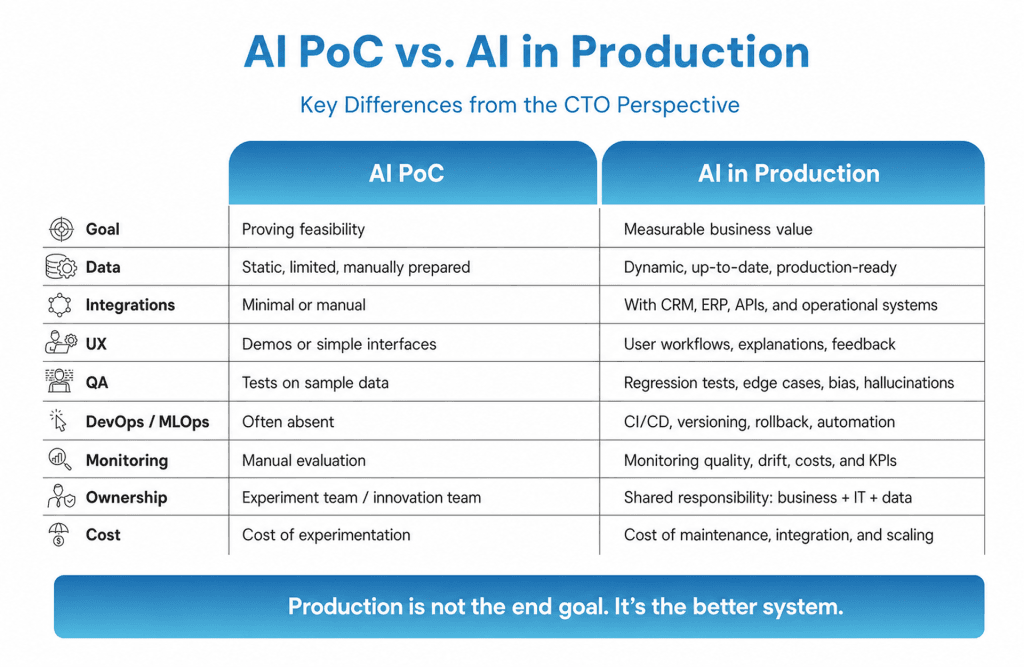

AI PoC vs production deployment: the key differences

AI PoC and a production solution
AreaAI PoCProduction deployment
GoalValidate whether the idea is feasibleDeliver a repeatable business outcome
DataLimited or manually prepared datasetStable pipelines, quality controls, versioning, and governed access
IntegrationsMocks, file exports, or a single APIIntegration with workflows, source systems, and authorization mechanisms
UsersSmall test groupReal users, roles, permissions, and error handling
TestingReview of selected examplesRegression suites and quality, security, integration, and performance tests
MonitoringUsually manualMetrics, logs, traces, alerts, and response procedures
CostCost of the experimentTCO covering models, data, infrastructure, testing, monitoring, and maintenance
OwnershipExperimental teamBusiness, product, and technical owners with a clear escalation path
Success criterionThe technology completed the taskThe process achieves the required outcome at an acceptable level of risk and cost

If a company keeps extending a PoC with new features but does not build the components required for production, it ends up with an increasingly expensive demonstration. It still does not have a product.

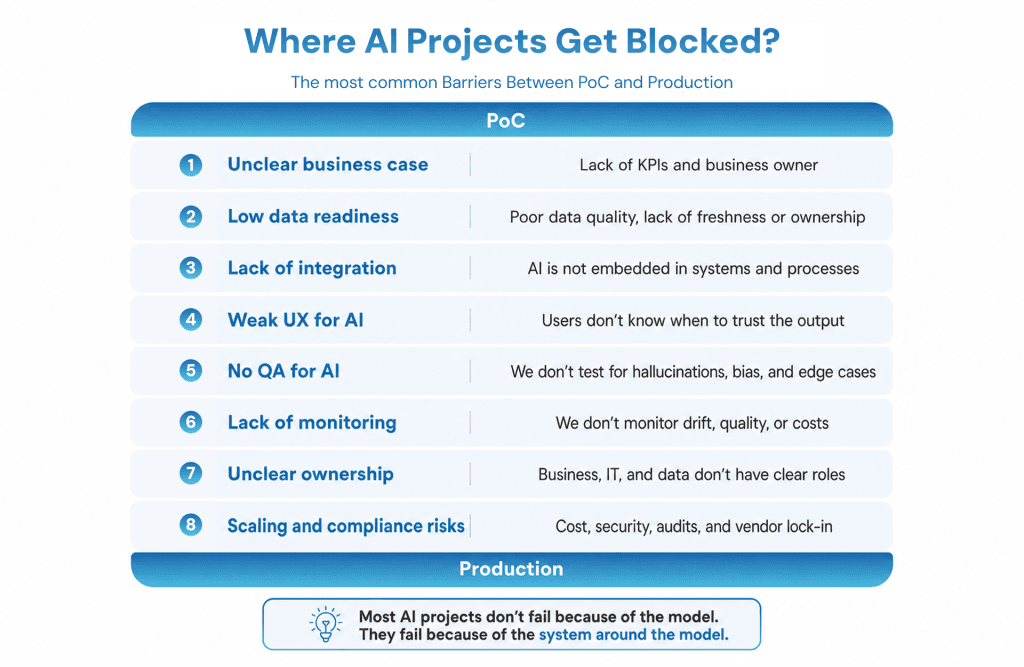

12 company mistakes that keep AI out of production

These mistakes rarely occur in isolation. They usually form a chain: choosing the wrong problem leads to weak KPIs, weak KPIs make the PoC difficult to evaluate, and unclear ownership means nobody funds the integrations, testing, and operations needed for deployment.

1. The company starts with technology, not a business problem

The project begins with the question, “Where can we use generative AI?” rather than with a costly, repetitive, or high-risk process. The team creates an impressive demo but cannot identify which business metric should improve because of it.

What this mistake looks like in practice:

  • there is no baseline against which the result can be measured,
  • different stakeholder groups expect different outcomes,
  • the PoC is judged by the quality of the presentation rather than the change in the process,
  • the project has no sponsor willing to fund the next stage.

What to do: define the problem, the process owner, the baseline, and the measurable outcome. AI should be one possible way to solve the problem, not the objective in itself.

2. Nobody owns the outcome of the solution

The AI team owns the model, IT owns the integration, business owns the process, and security owns compliance. If nobody is accountable for the result of the complete solution, decisions are postponed, risks are pushed between teams, and the production backlog has no single priority.

What to do: appoint one product or process owner who is accountable for the business outcome, budget, priorities, and risk acceptance. The technical owner should be responsible for architecture and operational readiness, but should not replace the business sponsor.

3. The PoC sits next to the process instead of inside it

A user exports a file from one system, pastes the data into a separate tool, and manually copies the result back into a CRM, ERP, or ticketing platform. Such a PoC may validate output quality, but it does not show the real impact on process time, error rates, or employee workload.

Risk signal: if the solution adds manual steps or operates outside the tool in which users already work, adoption after deployment may be far lower than during the pilot.

What to do: during discovery, design the target workflow, integration points, the moment at which a decision is handed to a human, and how the output will be stored in the system of record.

4. The company measures the model but not the process

Accuracy, groundedness, relevance, or F1 score matter, but they do not answer whether the company is gaining value. A solution can produce good answers while still making the process slower because employees spend too much time verifying every output.

What to do: connect model metrics to process KPIs. Examples include:

  • case handling time,
  • number of escalations,
  • percentage of outputs accepted without correction,
  • cost per case,
  • number of high-impact errors,
  • user adoption.

5. The data used in the PoC is better than production data

The experiment uses a manually selected, cleaned, and labelled dataset. Production introduces duplicates, missing fields, outdated documents, inconsistent formats, incorrect permissions, and data that should not be shared with the model.

What to do: before approving production, review data sources, quality, update frequency, lineage, access rules, retention, and responsibility for correcting errors. In RAG solutions, also assess document chunking, metadata, retrieval quality, and index refresh processes.

If the organization has not yet established sufficient data and process readiness, start with an AI readiness assessment.

6. The team underestimates enterprise integration costs

The model is only one component of the solution. Production AI must work with source systems, APIs, queues, databases, identity management, logging, consent mechanisms, and business workflows.

The largest delays often come not from model development, but from:

  • the lack of a stable API,
  • legacy system limitations,
  • inconsistent data identifiers,
  • lengthy access approval processes,
  • the lack of a test environment,
  • unclear ownership of dependent systems.

What to do: prepare a dependency map and the critical integration path before solution hardening begins. In some projects, the right decision is to modernize a selected layer, create an API, or restructure the data flow first.

7. Testing ends after reviewing a few correct outputs

During a demo, the team selects examples on which the system performs well. Production requires answers to additional questions: what happens when data is incomplete, a request is ambiguous, an API fails, the model changes, the prompt is updated, or someone attempts to manipulate the system?

What to do: build a versioned test set covering standard, edge, and prohibited scenarios. Every change to a prompt, model, data source, or tool should pass a level of regression testing appropriate to the risk of the use case.

8. Security is reviewed only just before deployment

Solutions based on large language models introduce risks that are not covered by conventional application testing alone. These include prompt injection, data disclosure, uncontrolled tool use, incorrect authorization, and excessive agent autonomy.

OWASP points out that excessive agency can lead a system to perform harmful actions based on unexpected, ambiguous, or manipulated model output. The number of tools, functions, and permissions should therefore be restricted to the minimum required for the task.

What to do: include security in the architecture from the start. Separate data from instructions, limit tool scope, apply least privilege, validate every action before execution, and design human approval for sensitive operations.

9. The company does not design error handling and fallback paths

Every system can fail, but an AI error does not always look like a technical outage. The answer may appear plausible while containing false information, a flawed recommendation, or an undesirable action.

What to do: define:

  • when the system should refuse to answer,
  • when it should escalate the case to a person,
  • how it should behave when data is missing or an integration fails,
  • how to roll back a model or prompt change,
  • how users will be informed about the solution’s limitations.

10. Monitoring covers API uptime but not AI quality

The system can meet its uptime SLA while producing progressively worse answers. Causes may include changes in data, user behaviour, the RAG index, the provider’s model, or prompt configuration.

What to do: monitor not only infrastructure but also output quality, high-impact errors, source usage, cost, latency, adoption, escalations, and signs of abuse. Alert thresholds and a named owner for each response are also required.

11. The business case ignores costs after scaling

PoC costs usually cover a small number of model calls and limited team involvement. Production adds infrastructure, tokens, data storage, evaluation, observability, support, regression testing, integration updates, and incident handling.

What to do: calculate the unit cost of the process at several usage levels. Compare at least three scenarios:

  • the current process without AI,
  • an AI-assisted process with human involvement,
  • a partially automated process.

In some cases, a conventional workflow, RPA, or semantic search will be more economical. It can help to compare RAG, fine-tuning, and workflow automation before committing to a production architecture.

12. The organization has no conditions for stopping the project

The more time and budget a PoC has consumed, the harder it becomes to admit that the solution should not be deployed. Teams add features, refine prompts, and replace models even though the core problem still lacks an owner, usable data, or a strong enough business case.

A mature decision: stopping a PoC is not always a failure. It may be the correct outcome of the experiment if it prevents a much larger investment in an unviable production deployment.

What to do: define GO, REWORK, and STOP criteria before the experiment begins. They should cover business value, quality, data, security, integration, cost, and the organization’s ability to operate the solution.

The most dangerous combinations of mistakes

A single weakness can usually be corrected. The greatest risk appears when several gaps reinforce one another.

Combinations of mistakes that block production
CombinationConsequenceFirst corrective decision
No owner + no business KPIsNobody can approve the cost and risk of the next stageAppoint a sponsor and define the required process outcome
Demo data + no regression suiteQuality falls on real data and the team cannot measure the regressionBuild a representative test set and production data pipeline
No integration + extra user stepsLow adoption and no real time savingRedesign the workflow and integration points
Broad agent permissions + no human approvalRisk of unauthorized or harmful actionsRestrict functions and validate operations before execution
No TCO model + rapid scalingSolution cost grows faster than the value createdRun a limited rollout and measure unit economics

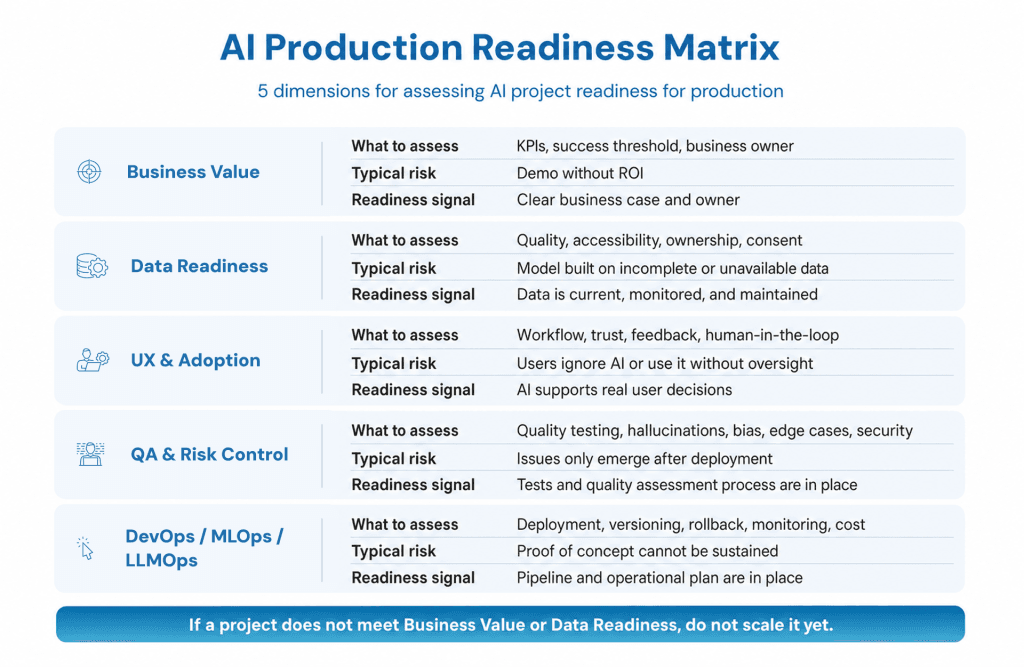

How do you assess AI production readiness?

AI production readiness is the readiness of the solution, process, and organization to use AI safely, repeatedly, and with a justified business case in a real operating environment.

The assessment should not end with a single score. A more useful approach is a set of decision gates, each addressing a different type of risk.

Eight gates for moving from AI PoC to production
GateDecision questionMinimum evidence of readiness
1. Business gateDoes AI improve a measurable process outcome?Baseline, KPIs, process owner, and expected benefit
2. Ownership gateWho is accountable for decisions, outcomes, and risk?Sponsor, Product Owner, technical owner, and RACI
3. Data gateIs the data available, current, and permitted for this use?Sources, quality controls, permissions, retention, and pipeline
4. Integration gateDoes the solution work inside the target workflow?Architecture, APIs, IAM, error handling, and output storage
5. Quality gateIs quality measurable and repeatable?Test sets, acceptance criteria, and regression testing
6. Security gateAre security and compliance risks controlled?Threat model, permissions, action validation, logs, and legal review
7. Operations gateCan the organization operate and support the system?Monitoring, alerts, rollback, incident management, and support
8. Economics gateDoes the full cost justify the value created?TCO, unit cost, scaling scenarios, and budget threshold

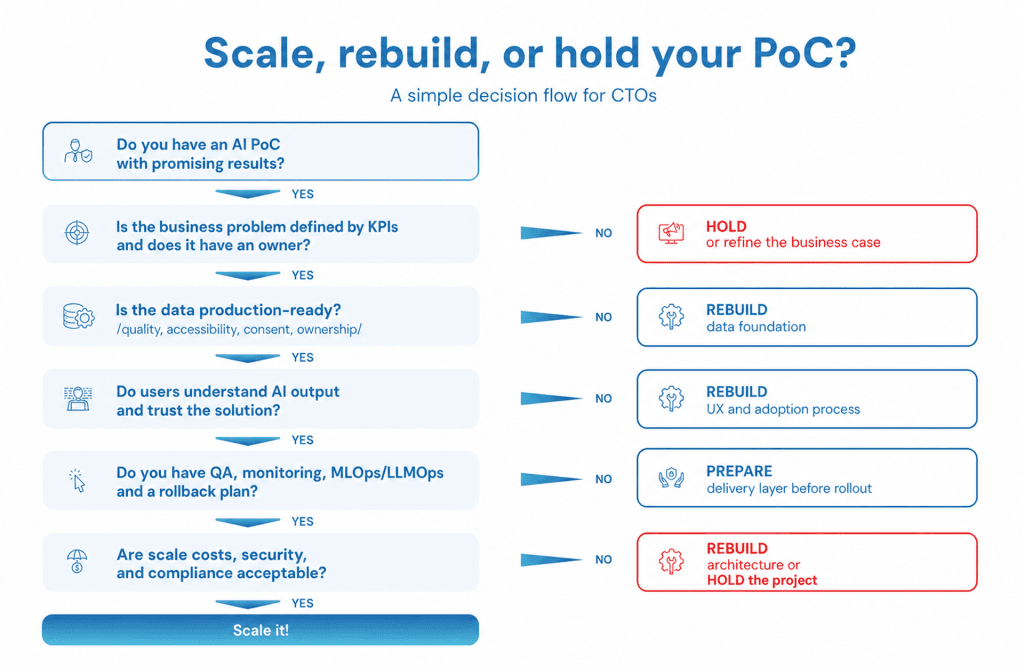

GO, REWORK, or STOP?

  • GO: all critical gates are satisfied, while the remaining gaps have an owner, deadline, and explicitly accepted risk.
  • REWORK: the business value is validated, but data, integrations, testing, or operations must be redesigned before deployment.
  • STOP: the project lacks accountable ownership, measurable value, a lawful way to use the required data, or an acceptable cost and risk profile.

The framework should not become a formal tick-box exercise. Its purpose is to expose dependencies that might otherwise block the project only after launch.

Who owns the move from AI PoC to production?

Production requires a broader team than the original PoC. This does not mean that every role must be full-time. It does mean that accountability cannot remain implicit.

Example division of responsibilities
RolePrimary responsibilityDecision that must have an owner
Business sponsorValue, budget, and acceptance of business riskDoes the project still justify investment?
Product Owner / process ownerPriorities, workflow, user needs, and acceptance criteriaWhat level of quality is sufficient for the process?
AI / Data LeadData, model, evaluation, and solution limitationsAre results stable and explainable enough?
Architect / Tech LeadArchitecture, integrations, scalability, and reliabilityDoes the solution fit the enterprise environment?
QA LeadTest strategy, regression, and evidence of qualityIs the risk of error acceptable?
DevOps / MLOps / LLMOpsDeployment, versioning, monitoring, rollback, and maintenanceCan a change be deployed and reversed safely?
Security / Compliance / LegalThreat model, data use, compliance, and usage constraintsCan this solution operate in this process and scope?

Risk signal: if every question about a system error is routed to the data science team, the organization probably has not yet established full product ownership for the AI solution.

How should an AI solution be tested before deployment?

AI testing cannot be reduced to manually checking a few responses. The test strategy must cover the complete system: the model, data, prompts, RAG, integrations, permissions, interface, and actions executed in other systems.

1. Business-value tests

  • Does the solution shorten or improve the target process?
  • Do users actually act on its recommendation?
  • Is the time saved cancelled out by the time required for verification?
  • Do errors create more cost than the benefit generated?

2. Output-quality tests

  • factual correctness,
  • alignment with source material,
  • completeness, relevance, and consistency,
  • resilience to ambiguous input,
  • behaviour when information is insufficient,
  • stability after a model or prompt change.

3. RAG and data tests

  • Does the system retrieve the correct sources?
  • Does it respect document-level access permissions?
  • Is the index current?
  • Are outdated sources removed or clearly marked?
  • Is the answer grounded in reliable context?

4. Integration and resilience tests

  • API or dependent-system failure,
  • timeouts, retries, and duplicate operations,
  • incomplete payloads and schema changes,
  • behaviour under load,
  • fallback and the ability to handle the process manually.

5. Security tests

  • prompt injection and indirect prompt injection,
  • attempts to disclose data or system instructions,
  • authorization bypass,
  • unsafe tool use,
  • execution without the required approval,
  • cost abuse and automated generation of excessive requests.

6. User and human-in-the-loop tests

  • Does the user understand the limitations of the AI?
  • Can the user verify the output?
  • Does the interface present sources and confidence in a useful way?
  • Is the escalation path fast enough?
  • Is human accountability real rather than merely formal?

Minimum package before deployment:

  • a versioned golden dataset or test set,
  • quality and security acceptance criteria,
  • automated regression for model, prompt, and RAG changes,
  • tests of critical integrations,
  • fallback and rollback scenarios,
  • documented limitations of the solution.

For high-impact use cases, the risk-management process should be aligned with established frameworks such as the NIST AI Risk Management Framework and should account for the threats identified in the OWASP Top 10 for LLM and GenAI Applications.

What should you monitor after launching AI?

Production AI monitoring must combine technical, quality, and business perspectives. API availability alone will not reveal that the system has started producing worse answers or that users have stopped trusting it.

Production AI monitoring areas
AreaExample metricsSignal requiring action
Business valueprocess time, cost per case, conversion, number of escalationsno improvement against baseline or deterioration of the process
Qualityacceptance without correction, high-impact errors, groundednessa rising correction rate or critical-error rate
Data and RAGindex freshness, retrieval effectiveness, missing sourcesanswers based on outdated or incorrect documents
Technologylatency, API errors, availability, resource utilizationSLA breaches or instability in dependent systems
Securityprompt-injection attempts, unauthorized actions, data leakagean action executed outside the permitted scope
Costcost per request, process, user, and modelcost grows faster than usage or value
Adoptionactive users, return to the old process, user feedbackusers bypass the system or ignore its recommendations

Every metric should have an owner, a warning threshold, and an agreed response. Without these elements, a dashboard is only a historical record.

When should you stop an AI project?

Not every gap requires the project to be closed. Some problems call for an additional technical or organizational stage. There are, however, situations in which further investment is not justified.

The project should receive a STOP decision when:

  • there is no measurable business problem or accountable process owner,
  • the value of the solution is lower than the cost of verification and maintenance,
  • the organization cannot lawfully or safely use the required data,
  • the acceptable error level is lower than what the architecture can achieve,
  • the process requires full determinism that the selected solution cannot provide,
  • integration with target systems is disproportionately expensive,
  • an effective fallback or human-control mechanism cannot be built,
  • reputational, legal, or operational risk outweighs the expected benefit.

The project should receive a REWORK decision when:

  • the problem and value are validated, but the PoC used unrepresentative data,
  • the result is promising, but the solution is not integrated into the workflow,
  • the architecture should change from an autonomous agent to a system with human approval,
  • RAG, workflow automation, or conventional rules would be more appropriate than the selected model,
  • the solution needs to be narrowed to a more homogeneous use case.

Important: stopping criteria should be established before the next investment stage. Otherwise, the decision will be influenced by sunk costs rather than future value.

A plan for moving from PoC to production

Not every project needs the same timeline, but the sequence of activities should reduce risk. The plan below can be adapted to the scale and criticality of the solution.

Stage 1. Assessment and decision

  • confirm the problem, baseline, and expected value,
  • review the eight production-readiness gates,
  • make a GO, REWORK, or STOP decision,
  • assign owners and budget.

Stage 2. Production design

  • design the target workflow and architecture,
  • define data sources and integrations,
  • set roles, permissions, and human-in-the-loop controls,
  • define quality, security, and SLA criteria,
  • build the cost model.

Stage 3. Solution hardening

  • build stable integrations,
  • automate pipelines and deployment,
  • create test suites and regression testing,
  • implement error handling, fallback, and rollback,
  • configure monitoring, logs, and alerts.

Stage 4. Limited rollout

  • launch for a small user group or selected process,
  • compare results against the baseline,
  • analyze errors and user behaviour,
  • measure unit cost,
  • decide whether to expand the scope.

Stage 5. Scaling and operations

  • increase traffic in controlled stages,
  • evaluate quality regularly,
  • manage model, prompt, and data versions,
  • run incident management and risk reviews,
  • reassess the business case continuously.

Good practice: scale the solution’s scope of responsibility before scaling the number of users. A system that supports a decision is usually a safer first step than a system that independently performs irreversible actions.

CTO checklist

Value and ownership

  • a specific business problem and baseline have been defined,
  • measurable process and AI-quality KPIs have been agreed,
  • a sponsor, Product Owner, and technical owner have been appointed,
  • GO, REWORK, and STOP criteria have been established.

Data and architecture

  • the representativeness of production data has been verified,
  • data access, retention, and update rules have been defined,
  • integrations with the target workflow have been designed,
  • legacy-system limitations and dependencies have been considered,
  • fallback and failure handling have been defined.

Quality and security

  • a versioned test set has been created,
  • quality thresholds and high-impact error limits have been agreed,
  • regression testing covers model, prompt, and RAG changes,
  • prompt injection, permissions, and agent actions have been tested,
  • operations requiring human approval have been identified,
  • solution limitations have been documented.

Operations and cost

  • monitoring covers quality, cost, and business value,
  • alert thresholds and an incident-management path have been established,
  • versioning and rollback are available,
  • unit cost and TCO have been calculated for several scaling scenarios,
  • the organization has the skills required for maintenance and further development,
  • a limited rollout is planned before full-scale adoption.

If several critical items still have no owner, the project is not ready for production, even if the demo performs flawlessly.

How does Edge One Solutions support production AI deployments?

Moving from AI PoC to production requires capabilities that extend beyond data science. The organization needs a team that can connect the AI solution with architecture, software, data, testing, security, and operations.

Edge One Solutions can support a selected stage or take responsibility for an agreed scope of delivery:

The key point: production AI is no longer a separate experiment. It becomes part of a business system and workflow, so it must be developed and operated under the same standards of ownership, quality, and security as other critical IT solutions.

Summary

AI projects do not stall between PoC and production because the model suddenly stops working. More often, the organization discovers that the experiment did not account for the full process, real data, integrations, ownership, security, and operating cost.

The most important conclusions are:

  • a PoC proves feasibility, not production readiness,
  • business value and ownership must be established before scaling,
  • AI quality should be measured together with the outcome of the process,
  • testing must cover the model, data, RAG, integrations, security, and user behaviour,
  • monitoring should combine quality, technology, cost, and business value,
  • a STOP decision can be the correct outcome of a PoC,
  • production requires combined AI, data, development, QA, DevOps, security, and business capabilities.

If your PoC works but the project is stuck before deployment, changing the model is not always the right next step. Start by reviewing the production gaps and determining which ones require a redesign of the solution, the process, or the way teams work together.

FAQ

Why do AI projects stall after the PoC?
Most projects stall because the PoC proves that the technology works but does not account for production data, integrations, testing, security, monitoring, operating costs, or ownership of the complete business outcome.
What is the difference between an AI PoC and a production deployment?
An AI PoC validates the feasibility of an idea in a limited environment. A production solution must work repeatedly on real data, integrate with the workflow, meet quality and security requirements, and have monitoring, accountable owners, and a justified cost of operation.
What does AI production readiness mean?
AI production readiness is the readiness of the solution, workflow, and organization to use AI safely, repeatedly, and economically in a real operating environment. It covers business value, ownership, data, integrations, quality, security, operations, and cost.
What tests should an AI solution pass before production?
It should pass tests of business value, output quality, data and RAG, integrations, performance, security, permissions, fallback behaviour, and user interaction. A versioned regression suite is also required.
Who should own an AI production deployment?
The business sponsor should own value and budget, the product or process owner should own priorities and acceptance criteria, and a technical team covering AI, data, architecture, QA, DevOps or MLOps, security, and compliance should own production readiness. The responsibilities should be documented in a RACI.
Which metrics should be monitored after AI deployment?
Monitor business outcomes, output quality, high-impact errors, data and retrieval performance, latency, availability, security events, unit cost, and user adoption. Every metric should have an alert threshold and a response owner.
When should an AI project be stopped after the PoC?
Stop the project when it lacks measurable value or accountable ownership, when the required data cannot be used lawfully, when the acceptable error threshold cannot be reached, or when the operating cost and risk are not justified. A STOP decision is a valid outcome when it prevents an unviable deployment.
Should every process be automated with generative AI?
No. Processes that require full determinism, simple rules, or very low operating cost may be better served by conventional automation, RPA, or workflow tools. The architecture should follow the problem, data, risk, and economics.
How can a technology partner help move an AI PoC to production?
A partner can assess readiness, design the target architecture and integrations, prepare the data layer, build testing, CI/CD, and monitoring, and provide the skills required to operate and develop the solution after launch.
